Together, these issues suggest the need for a more integrated approach to land use planning and policy initiatives to create safe, resilient, and affordable communities.
Incremental Housing Units Needed vs Current Zoning Capacity
Analysis considers the incremental housing stock unlocked by the adopted reforms from “City of Yes Housing Opportunity.” Regional Plan Association based on National Zoning Atlas (Long Island and Westchester), New York City Department of City Planning (MapPluto 2023), City of Yes Final Environmental Assessment Statement (CEQR # 24DCP033Y), 2020 Decennial Census, American Communities Survey Table DP04 2023 1-Year, New York Panel Climate Change (NPCC), FEMA Hazus Flood Loss, Urban Footprint Base Canvas, and RPA Gateway and the Post-Covid Economy (2022).
The scale of the deficit provides insights into the necessary scope of zoning reform and additional policies needed to address housing and climate adaptation needs in the study area. By contextualizing this gap at the local level, the report also documents relevant policies and planning tools to be leveraged and prioritized based on the built environment, infrastructure, and flood hazard conditions of neighborhoods and localities across the region.

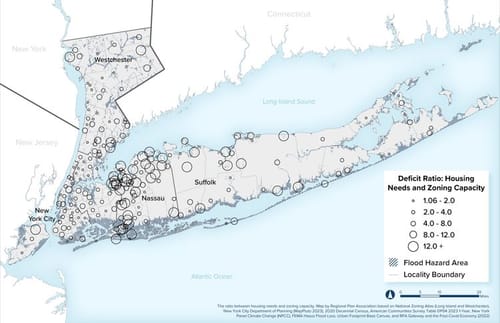

Deficit Ratio by Locality with Flood Exposure by 2040
The ratio between housing needs and zoning capacity. An estimate of how many times zoned capacity has to increase to meet housing needs fully. Residential zoning capacity can be increased by broadening the geographic scope of multifamily districts and creating more flexible regulations that govern building treatments, density, parking requirements, and other dimensional criteria. For more detailed information, visit this link to the web map version.
Key Terminology
Study Area: New York City, Long Island, and Westchester County. Estimates have been disaggregated by community districts in New York City and municipalities in the suburbs.
Housing Needs: Refers to the requirement for housing that meets individuals’ and households’ current and prospective needs. To quantify needs within the study area, this report utilized estimates of overcrowded households, vacancy rates, and the temporarily sheltered population, along with projections to the year 2040 for household formation, dilapidation rates, and units lost to flooding.
Zoning Capacity: Potential additional residential units allowed under current zoning regulations and as-of-right conditions. This estimated build-out was based on parcel-level analysis and applicable zoning regulations, including recent reforms implemented in New York City under the City of Yes Housing Opportunity proposal.
Net Deficit: The difference between housing needs and zoning capacity (build-out), measured in number of dwelling units (DU).
Deficit Ratio: The ratio between housing needs and zoning capacity. An estimate of how many times zoned capacity has to increase to meet housing needs fully. Residential zoning capacity can be increased by broadening the geographic scope of multifamily districts and creating more flexible regulations that govern building treatments, density, parking requirements, and other dimensional criteria.
Smart Growth: Planning approach to create more livable, sustainable, and equitable communities by focusing on compact, mixed-use development, walkable neighborhoods, and diverse transportation options.
Flood Exposure: Represents the potential for damage based on a property’s location and population’s vulnerability to flooding. Estimates are based on storm surge and sea-level rise projections for 2040 and 2070.
Flood Loss: Refers to the actual damage and non-replacement of housing stock incurred due to a flood event. For housing flood loss to occur, exposure must be frequent and/or severe enough to result in significant damage.
Findings and Recommendations Summary
All statistics are based on New York City, Long Island, and Westchester County (study area).
Flood Exposure and Loss
- By 2040, as many as 1.6 million people in the study area could live in an area exposed to flooding, with 1 million in the urban core and regional downtown centers (63%). In the coming years, more than 1 million jobs could be located in areas with future flood exposure, with approximately 726,000 in higher-density urban locations.
- Around 77,300 acres of residential-zoned land in New York City and its surrounding suburbs may face flooding by 2040. This at-risk area amounts to 10.5% of the zoned land allowing for some form of residential use on an as-of-right basis.
- The study area could lose as many as 82,000 housing units due to flooding by 2040, and the number could double to 160,000 by 2070. These housing losses could occur in 78% of municipalities in the study area suburbs (124 out of 159) and 60% of community districts in New York City (30 out of 55).
Current and Prospective Housing Needs
The region’s total housing needs (current and prospective) could reach 1.26 million additional units by 2040, representing a needed increase of 24% from the current stock.
362,000 housing units are required to address current needs, including overcrowding, the temporarily sheltered population, and low vacancy rates. Another 895,000 units could be required by 2040 to address prospective needs, such as flood loss, dilapidation, and household formation.
Zoning Capacity and Deficit
The study area’s potential zoning capacity (build-out under current zoning regulations) represents approximately 580,000 units, with 390,000 in New York City and 190,000 between Long Island and Westchester.
The zoning capacity represents less than half (45%) of the total housing needed by 2040, leaving a net deficit of approximately 680,000 units. To accommodate current and prospective needs of 1.26 million additional units by 2040 and to account for flood-related losses of up to 82,000 housing units, zoning development capacity would need to increase by a factor of 2.2 (the “deficit ratio”).
Nearly all residentially zoned land permits single-family residences on an as-of-right basis: 100% in NYC, and 98%, and 96% on Long Island and in Westchester County, respectively. Despite their proximity to New York City, Suffolk and Nassau Counties (which makeup Long Island) ban multifamily residential development on 96% and 93% of their residential land, respectively.
Lot size requirements are a significant impediment to development in the suburbs. Approximately 45% of underdeveloped properties in the study area suburbs cannot be developed because they do not meet the required minimum lot sizes.
Zoning reforms adopted in New York City under the “City of Yes” Housing Opportunity could add 82,000 additional housing units to the city’s housing stock, which brought a 758,000 gap in the study area down to 676,000, or an 11% decrease, a modest improvement in addressing the housing deficit within the study area.
Recommended Policies and Tools
Housing and resiliency goals must acknowledge needs that are both regional in scale and dynamic in time. Efforts to minimize flood risk and close the housing deficit should also consider local flood exposure conditions and attributes that favor “smart growth” through compact, walkable, and transit-oriented development which takes advantage of both our urban mass transit and our extensive suburban rail network.
Neighborhoods and areas with lower anticipated flood exposure and greater potential for smart growth development should facilitate transit-oriented development, mixed-use multifamily buildings, and infill development. Sustained investments will also be required to enhance the capacity and resilience of services and infrastructure.
Areas facing significant risks from future flooding and a high potential for smart growth development will require comprehensive planning to promote growth while protecting existing communities and infrastructure through flood-resilient design and other adaptive measures.
Neighborhoods and localities that are highly exposed to future flooding and have relatively low potential for smart growth may require different strategic approaches, such as managed retreat and reprogramming existing land use, including restrictions on certain types of residential development.
Areas with low levels of future flood loss and low potential for smart growth development can benefit from targeted interventions to enhance livability and sustainability while avoiding sprawl through adaptive reuse and middle-density buildings.
Policymakers and planners usually focus on population growth and affordability when deciding how many homes a community or region needs. But what if the land we plan to build on is prone to flooding? These climate-related factors must be integrated into our housing needs assessments to ensure we’re building safe, resilient, and sustainable communities for the future.
By 2040, around 77,300 acres of residential-zoned land in New York City and the study area suburbs – or 10.5% of such land – may face flooding. Suffolk County has the largest acreage of residential districts exposed to future flooding, with approximately 37,800 acres or 10% exposed. New York City follows, with approximately 20,900 acres of residential districts exposed to flooding, representing 15% of the city’s total. By 2040, up to 10% of the people in the study area might reside in areas prone to future flooding. With more than 1 million people at risk in the urban core and regional downtowns, 63% of the potentially affected population could be living in higher-density urban areas. An additional 1 million jobs could be situated in zones vulnerable to future flooding, with approximately 726,000 in the urban core and regional downtown regions areas. Hazards include storm surge, riverine flooding, and sea level rise projections based on New York Panel Climate Change (NPCC) 16″ of sea level rise by 2040 (75th percentile).
Flood Loss
Flood exposure represents the potential for damage based on a property’s location and vulnerability to flooding. In contrast, flood loss refers to the actual damage or financial loss incurred due to a flood event. For residential loss to occur, exposure must be frequent and/or severe enough to result in significant damage. Aside from the degree of exposure, socioeconomic conditions, building regulations, and insurance policies can influence whether a housing unit is lost.
According to the RPA estimates, communities in New York City, Long Island, and Westchester (the study area) could lose up to 82,000 housing units due to permanent, chronic, and coastal flooding, doubling to 160,000 by 2070. These estimates are focused only on flooding, but a more complete assessment should have a multihazard perspective (e.g., extreme rainfall or wildfires).
Housing losses by the year 2040 could occur in 78% of municipalities in the suburbs (124 out of 159) ) and 60% of community districts in New York City (30 out of 55). The most flood-prone areas where the largest losses may occur are the towns of Hempstead, Babylon, Islip, Brookhaven on Long Island and cities in Westchester County along the Long Island Sound. Each could lose over 6,000 units by 2040. Neighborhoods in New York City like Rockaways, South Ozone Park, and Canarsie could also be significantly impacted, with each area losing over 2,000 units.
For this analysis, RPA considered lost housing resulting from two types of hazards: sea-level rise and storm-related flooding.
Sea-level rise refers to gradual, permanent, or chronic inundation. Using the projections developed by the New York Panel on Climate Change (NPCC) and a bathtub model, RPA calculated the number of housing units exposed to monthly high tides and considered them lost. We developed a range of estimates based on the NPCC’s 25th and 75th percentiles and projections for 2040 and 2070.
In addition to sea-level rise, RPA also factored storm-related flooding, which refers to acute, random, and temporary flooding. We used FEMA’s basic Hazus-generated depth grids for damage analysis over multiple return periods (10, 50, 100, and 500-year storm events). When a portion of a building was likely to receive substantial damage (>50%) in the time interval, RPA considered them destroyed. We assumed 50% of substantially damaged homes would be replaced under the low scenario and 0% replacement of substantially damaged homes under the high scenario. As with the sea-level rise estimates, we produced projections for 2040 and 2070.
Housing Flood Loss Estimates by Subregion and Decade
RPA analysis based on New York Panel Climate Change (NPCC), FEMA Hazus Flood Loss, 2020 Decennial Census, and American Communities Survey Table DP04 2023 1-Year
Housing Units by County: Existing in 2023 vs Cumulative Needed Through 2040
RPA analysis based on ACS Table DP04 2023 1-Year, New York Panel Climate Change (NPCC), FEMA Hazus Flood Loss, Gateway and the Post-Covid Economy (2022), and McKinsey Co. Affordability Squeeze (2024).
Current Housing Needs
RPA estimates that about 362,000 additional housing units are necessary to meet immediate needs in New York City, Long Island, and Westchester. To define current housing needs, RPA considered vacancy rates (for rent and sale), overcrowded households, and temporarily sheltered populations.
Low vacancy rates are strongly associated with higher costs for both renters and prospective home-owners. To address the region’s low vacancy rates, an estimated 132,000 units are required. In New York City, apartments available for rent dropped to a minuscule 1.4% in 2023. Vacancy rates in the Metro area range between 1% for sale and 2.9% for rental units. Respectively, these figures are well below the 3.5% and 5% rates that represent a well-functioning buyer and rental housing market.
Overcrowded units represent roughly half the current needs in the study area. According to census estimates, 370,800 households in the study area are overcrowded, 314,000 in NYC (85% of the share). Overcrowding also disproportionately affects workers and low—and moderate-income families, which provides insights into the scale of the current need for affordable housing.
Homelessness is also strongly connected to market conditions and, as such, serves as another critical indicator to consider when assessing housing needs. There are approximately 150,000 homeless people within the study area; 130,000 are in the NYC shelter system, and over 20,000 live on Long Island and in Westchester County. In recent years, homeless families have grown as a share of the overall sheltered population, now accounting for more than ⅔ of the temporary sheltered. Permanently housing this population would require between 40,000 and 50,000.
Current Housing Units Needed by County and Category
RPA analysis of 2020 Decennial Census, ACS Table DP04 2023 1-Year, and NYC Housing Vacancy Survey 2023.
The following maps show the distribution of housing needs by NYC neighborhoods and for suburbs in the study area. By contrasting needs by category, the maps also show how each locality has a unique housing profile, with the mix between current, prospective, and flood loss-related needs varying depending on location. Generally, suburban localities have a profile where prospective housing needs represent a more significant proportion of their total. Municipalities in Long Island show a higher share of flood loss-related needs when compared to New York City and Westchester counties. In contrast, areas in the urban core show a profile where the proportion between current and prospective housing needs is more even.
As communities in America confront the pressing issues of high housing costs, underutilized land, and deteriorating neighborhood conditions, an increasing number of local officials are acknowledging that zoning regulations contribute to these problems – and that zoning reforms can help solve them. Even though villages, towns, and locally elected officials across the region may seem to have little control over global emission trends and their related hazards, they greatly influence zoning regulations. These local stakeholders hold a key policy lever in maintaining zoning rules that control where we can build or retreat from, with significant implications for climate mitigation and adaptation efforts. In aggregate, the existing land use rules remain overly prescriptive, disjointed, and insufficient to address the challenges of a regional housing market facing a severe deficit and increasing flooding exacerbated by climate change.
Housing Deficit
Using a first-of-its-kind database of zoning laws produced by the National Zoning Atlas, RPA estimated the zoning development capacity within Long Island and Westchester. We also estimated the development capacity of New York City, including the recent reforms implemented under the City of Yes Housing Opportunity initiative and using the city’s Primary Land Use Tax Lot Output (MapPluto) dataset. We then produced a gap analysis by comparing this build-out against housing needs, including prospective and flood loss-related.
The analysis reveals that the current residential zoning development capacity allows less than half (45%) of the total housing needed by 2040, leaving a net deficit of approximately 680,000 units. To meet both current and future needs, including losses related to flooding, zoning development capacity would need to increase by a factor of 2.2 (the “deficit ratio”).
The following table and maps illustrate the distribution of the housing deficit across community districts in New York City and suburban localities within the study area. Although neighborhoods in the urban core typically have greater zoned capacity, the housing needs in these areas are also significantly larger. Consequently, the net deficit is concentrated in the urban core. However, the spatial distribution of the deficit ratio (number of times zoned capacity has to increase to meet housing needs) highlights a critical need to significantly increase capacity in the inner suburbs, particularly in Nassau County, and in some instances by a factor much higher than current zoning regulations.
Deficit: Incremental Housing Units Needed vs Current Zoning Capacity
Analysis factors the incremental housing stock unlocked by the adopted reforms from “City of Yes Housing Opportunity.” RPA based on National Zoning Atlas, New York City Department of City Planning (MapPluto 2023), City of Yes Final Environmental Assessment Statement (CEQR # 24DCP033Y), 2020 Decennial Census, American Communities Survey Table DP04 2023 1-Year, New York Panel Climate Change (NPCC), FEMA Hazus Flood Loss, Urban Footprint Base Canvas, and RPA Gateway and the Post-Covid Economy (2022).
This gap is based on the potential build-out under current zoning, which could allow as many as 580,000 housing units on an as-of-right basis. This includes 390,000 units in New York City and 190,000 across Long Island and Westchester. The estimates also assume that all underdeveloped properties are built to the maximum allowed density. The buildout capacity was based on parcel-level analysis and applicable zoning regulations, including recent reforms implemented in New York City under the City of Yes Housing Opportunity initiative.
Zoning and Residential Land
As a whole, zoning in the region is permissive for sprawl but very restrictive for multifamily development. Suburbs (particularly those in Long Island) prohibit multifamily development within most zoning districts. Single-family residences are permitted on an as-of-right basis on nearly all residentially zoned land: 100% in NYC, 98%, and 96% in Long Island and Westchester, respectively. While multifamily buildings with four units or more are allowed on 61% of New York City’s residentially zoned land, they are allowed on less than 5% of the land in the suburbs. Despite their proximity to New York City, Suffolk and Nassau Counties ban multifamily residential development on 96% and 93% of their residential land, respectively. Restrictive zoning that does not allow for multifamily housing—even moderately sized—makes it much more challenging to address the housing crisis experienced in the region and beyond.
Zoning Treatment and Residential Land
New York Suburbs: Zoning Capacity Analysis
RPA estimates that as-of-right residential zoning in Long Island and Westchester allows a potential build-out of approximately 190,000 units. This assumes that all viable underdeveloped properties (i.e., soft sites) are built to their maximum allowed density.
To arrive at this estimate, RPA first linked the NZA zoning attributes to parcel-level data, starting with 470,000 parcels in the suburbs. These parcels were based on non-residential and residential underdeveloped lots, then subjected to a multi-step screening process to identify likely development sites (i.e., soft sites). The screening involved several tests based on zoning regulations and parcel attributes (e.g., does the parcel meet the minimum lot size requirement? Is the allowable density much larger when compared to the existing?). Of the initial 470,000 parcels evaluated, approximately 49,500 passed the tests and were considered part of the build-out calculation.
For the parcels that remained after the screening process (49,500 lots), we calculated the maximum number of dwelling units (DUs) allowed on an as-of-right basis, as determined by the corresponding building treatments. For multifamily districts (allowing four or more units), we used lot size information, allowed DUs per Acre, and maximum Floor Area Ratio (FAR) to estimate the maximum number of units allowed per site. In addition, we conducted a series of building envelope studies based on the bulk control regulations applicable to multifamily districts (four or more units). Wherever necessary, we adjusted residential density to reflect instances where the maximum of DUs per Acre was not achievable due to other constraints and dimensional criteria (i.e., lot coverage or height limitations). The residential build-out estimates were produced on a parcel level and then aggregated to their corresponding locality.

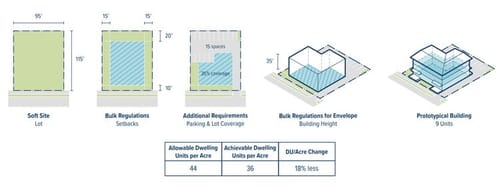

Envelope Study Example
An illustrative example of an envelope study for a soft site where, according to the zoning ordinance, the maximum allowable density is 44 DU/acre, but the resulting achievable density is 36 DU/acre once all other zoning requirements are met. The site has an 18% reduction in achievable residential density compared to what is indicated in the zoning ordinance.
Zoning Capacity and Housing Needs in New York City Before and After City of Yes
The analysis considers the incremental housing stock unlocked by the adopted reforms from “City of Yes Housing Opportunity.” RPA based on National Zoning Atlas (Long Island and Westchester), New York City Department of City Planning (MapPluto 2023), City of Yes Final Environmental Assessment Statement (CEQR # 24DCP033Y), ACS Table DP04 2023 1-Year, New York Panel Climate Change (NPCC), FEMA Hazus Flood Loss, and Gateway and the Post-Covid Economy (2022).
Achieving meaningful housing and resilience goals will require regional thinking. However, the policies and tools needed to advance these objectives will be implemented in specific neighborhoods and localities. Therefore, understanding localized characteristics related to potential growth and flood risk while maintaining a regional perspective will be crucial for both minimizing exposure to flood risk and reducing the housing deficit. This chapter identifies four types of communities – Smart Growth Haven, Resilient Refuge, Adaptive Retreat, and Stable Support – and offers recommendations for goals and strategies for each.
Some places already have infrastructure and built-form conditions that encourage growth in compact, walkable, and transit-oriented development, while others do not display these characteristics. Certain locations have relatively low exposure to future flooding, whereas others are highly vulnerable. By comparing local attributes associated with flood risk and smart growth potential. RPA defined four “area types,” each with a distinct combination of the two variables. These four area types can be used to categorize the various neighborhoods and localities throughout New York City and its suburbs, identifying respective policy priorities to address regional needs.

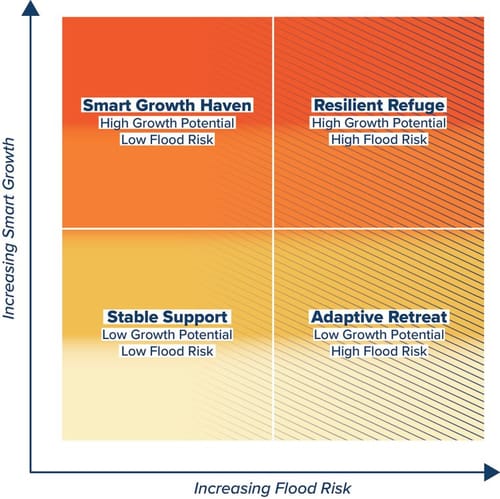

Smart Growth and Flood Risk Matrix
The following area types do not represent forecasts or prescribe policy. Whether a neighborhood or locality falls into any of these categories will depend on the choices made in the coming years and decades, the extent of collaboration between public and private entities, evaluation of needs and acceptable degree of risk, and the level of coordination at the local, state, and federal levels. These types are based on the challenges and opportunities presented by a location’s built and natural environment and provide an overview of potential planning interventions and policies aimed at minimizing risk and addressing the housing deficit. Depending on conditions, these policies and programs could be deployed across the full range of growth and risk profiles depicted in the diagrams. However, the following policies should not be considered exclusive to a given type. Depending on conditions, these policies and programs could be deployed across the full range of growth and risk profiles depicted in the diagrams.
Smart Growth Area Type Current & Future Conditions
Goals and Policy Priorities:
Housing need assessments: Evaluate and determine current and future housing requirements at the local and regional levels. Consider immediate needs such as overcrowding, temporary sheltered population, and vacancy rates. In addition, evaluate future demand resulting from household formation, dilapidation rates, and flood loss.
Housing action plan: Establish goals and prioritize actions based on comprehensive need assessments. Identify land use actions, policy changes, and site-specific interventions to facilitate growth in proportion to regional housing needs.
Zoning capacity: Expand residential zoned capacity proportionately to regional housing needs and future demand.
Housing types and uses: Broaden the geographic scope of zoning districts that allow for multifamily development and residential middle-density typologies.
Transit-Oriented Development: Promote TOD and other forms of infill by utilizing special districts, overlays, and building treatment regulations in relation to transit proximity.
Approval processes: Expedite public and environmental review procedures for multifamily and infill development.
Bulk and use regulations: Implement flexible zoning and land use regulations that govern building treatments, density, parking requirements, and other dimensional criteria (lot coverage, setbacks, height, etc.).
Financing and funding: Prioritize and leverage financing and discretionary funding programs (e.g., the New York Pro-Housing Community, Downtown Revitalization, and NY Forward programs) to promote sustained growth,
Affordable housing: Encourage affordable housing by implementing inclusionary zoning and other strategies.
Infrastructure: Make sustained investments to enhance and expand the capacity of infrastructure, services, and utilities.
Policies that affect Smart Growth Havens should focus on removing obstacles to housing development and building necessary programs and infrastructure to support that growth. Local authorities must actively boost capacity through upzoning and adaptable regulations. State and federal governments can also establish goals and benchmarks by performing regional housing assessments, simplifying public and environmental review processes for specific projects, and assisting in aligning land use changes with incentives and funding priorities. Development should follow established good urban design principles, contributing to a healthy and beautiful built environment.
Decision-makers in Smart Growth Havens must also prioritize maintaining and enhancing supporting infrastructure while making it more resilient. This involves securing sufficient funding for operations and maintenance, investing in robust public transit, expanding public utilities’ capacity, and upgrading sewer systems, among other initiatives. These improvements should occur alongside or in anticipation of residential development.
Resilient Refuge (High Risk - High Growth)
This category identifies areas with compounding adaptation needs: significant risks from future flooding and a high potential for smart growth development. These locations will require comprehensive planning to promote growth while protecting existing infrastructure and communities through flood-resilient design and other adaptive measures.
Resilient Refuge Area Type Current & Future Conditions
Goals and Policy Priorities:
Housing need and climate risk assessments: Assess and quantify potential housing needs and climate risks. Establish goals and actions based on forward-looking needs assessments within a regional context.
Zoning capacity: Expand residential zoned capacity proportionately to regional housing needs and demands.
Capital budgeting: Align budget scope and priorities with growth and adaptation needs. Prioritize and secure community investments and funding where growth can be encouraged and accommodated. Improve and expand infrastructure and services, such as transit, sewers, and resiliency projects, to address current and future needs.
Special districts: Develop districts with incentive-based zoning (e.g., Waterfront Access Zoning), assessment fees, or tax increment financing mechanisms to help pay for adaptation projects and infrastructure maintenance.
Building standards for resilience: Update codes to ensure that buildings can withstand and recover from adverse events and extreme weather while reducing exposure in surrounding areas.
Shore-based measures: Protect the coast from erosion, flooding, sea level rise, and damage to coastal communities and infrastructure. Depending on the location and specific needs, these measures can include hard engineering solutions like sea walls, revetments, land elevation, and levees, or soft engineering techniques and natural processes, such as beach nourishment and the restoration or creation of dunes and wetlands.
Sewer systems: Expand or retrofit the capacity of the sewer network, pumping stations, and other structures that collect, move, and treat wastewater and stormwater.
Green infrastructure: Expand natural systems and engineered solutions into the built environment to manage stormwater, mitigate coastal flooding, and enhance climate resilience.
Resilient Refuge locations face the dual challenge of managing significant climate risks while accommodating substantial housing growth. To effectively tackle this complexity, these areas must prioritize policies that integrate climate resilience with housing development. Comprehensive risk and needs assessments should be conducted to inform strategic investments in resilient infrastructure and development. Capital budgets and reliable sources of resilience funding should align with both growth and adaptation needs, providing targeted support for vulnerable communities. These areas can lead efforts at the intersection of climate change and the housing crisis, serving as examples of sustainability.
Key policy levers to encourage housing growth include upzoning, creating special districts or overlays, and offering development incentives. Integrating affordable housing into new developments will benefit current residents and vulnerable populations. Environmental design standards should be developed to incorporate sustainable systems into buildings.
Investing in public transit and existing infrastructure is vital for maintaining essential network services. Shore-based measures, along with storm surge barriers in some cases, will be critical for reducing flood risks. Strategically designing green infrastructure and open spaces can effectively manage flooding while enhancing urban landscapes. These improvements should be implemented alongside or in anticipation of residential development.
Adaptive Retreat (High Risk - Low Growth)
This typology represents neighborhoods and localities that are highly exposed to future flooding and have relatively low potential for smart growth.
Adaptive Retreat Area Type Current & Future Conditions
Goals and Policy Priorities:
Managed retreat: Implement strategies that support the purposeful, coordinated, and voluntary movement of people and residential buildings away from risks over time. This may involve the movement of individuals, infrastructure (e.g., building or road), or community. Include incentives that keep residents within the same town or county. Areas highly exposed to flooding can be reprogrammed to facilitate low-risk uses, such as community centers and open spaces with active and passive recreation options.
Buyout programs: Implement programs for voluntary acquisitions that require permanently removing properties from high-risk areas. After a structure is removed, strict land use management measures are typically imposed. Develop programs to support low-income homeowners and renters, including bonuses to keep residents within the town or county. Create buyout programs for both single- and multi-family properties that are effective, equitable and address the needs of both owners and renters.
Special districts/flood risk zones and overlays: Create districts where flood risk zoning/building codes and development standards apply. Facilitate transfer of development rights (TDRs) using special districts or credits.
Shore-based measures: Safeguard the coastline against erosion, flooding, rising sea levels, and damage to coastal communities and infrastructure. Leverage opportunities to restore the coastal edge, delivering natural protective benefits and economic advantages of ecotourism. Facilitate wetland migration where suitable.
Green infrastructure: Expand natural systems and engineered solutions into the built environment to manage stormwater, mitigate coastal flooding, and enhance climate resilience. Pair widespread green infrastructure with hard infrastructure to aid in long-term resiliency as well as add a sense of “place” and nature.
Adaptive Retreat communities in this category must prioritize addressing risk and safety concerns related to flood hazards. Instead of focusing solely on disaster recovery, they should reframe timelines and design for long-term adaptation. Localities should utilize land use authority to discourage residential development and assist homeowners and renters in relocating away from flood hazards. Areas highly exposed to flooding can be reprogrammed to facilitate low-risk uses, such as community centers and open spaces with active and passive recreation options. Transparent and consistent communication between authorities and residents is essential for equitable planning within adaptive retreat areas.
Proactive movement away from hazards can be achieved through acquisition programs, managed retreat plans, special districts and overlay zones, and, in cases of very serious risk, using eminent domain. Managed retreat plans should comprehensively understand which specific areas of a locality are at risk and which areas could be targeted for growth, ideally including incentives to retain residents within the locality. Special districts/flood zones and overlays can facilitate the transfer of development rights and establish zones where strict building codes, development standards, and zoning restrictions apply. Applicable ranges of risk should be accurately conveyed to homeowners and developers through the stringency of building codes and the cost of property insurance to deter development in higher-risk areas.
In addition to relocating from hazards, these areas must also focus on mitigating future risks. Shore-based strategies and green infrastructure can create opportunities to restore a coastal or riverine edge that offers both ecological benefits and flood protection. Residents who choose to remain should not experience a decline in their quality of life. The transformation of these areas into regional open spaces or park networks centered around ecotourism should be considered.
Stable Support (Low Risk - Low Growth)
The Stable Support category encompasses areas with low levels of future flood loss and low potential for smart growth development. These areas can benefit from targeted interventions to enhance livability and sustainability while avoiding sprawl through adaptive reuse and middle-density buildings.
Stable Support Area Type Current & Future Conditions
Goals and Policy Priorities:
Adaptive reuse: Facilitate mixed-use development and adaptive reuse of underutilized/vacant properties, whether commercial, vacant, or parking lots. Facilitating this can also help compatible uses to be near each other and for housing to be added, especially along existing commercial or transit hubs.
Middle density: Gradually increase housing density in existing neighborhoods, adding more homes (e.g., Accessory Dwelling Units (ADUs), duplexes, and triplexes) without disrupting the neighborhood’s character.
Housing fund contributions: Create funds to incentivize affordable housing that can be credited elsewhere. Create funding obligations to subsidize non-profit and for-profit developers to build or substantially rehabilitate multi-family apartments within a certain jurisdiction.
First- and last-mile connections: Improve the final segment of a person’s journey between the main transit system (e.g., the bus or train network) and the rider’s final destination.
Fair share: Adopt legal requirements for municipalities to provide a fair share of affordable housing for their region. Calculations are usually based on population size, jobs, income, and underdeveloped land. Allocate and build affordable housing units for vulnerable populations and various income levels.
Stable Support communities should prioritize land-use changes along existing transit and commercial corridors to encourage mixed-use development, increase density, and enhance connectivity within their built environment. The most appropriate approach for these areas is incremental development at a moderate density paired with gradual transit improvements.
Specific policy tools, such as adaptive reuse , middle density , parking reductions, fair share housing allocations, and contributions to housing funds, are recommended to support this incremental housing development approach. Additionally, localities should concentrate on expanding and enhancing the connectivity of public transit and active transportation networks to improve accessibility and mobility.
Illustrative Future Area Types within Matrix
Conclusion
Housing and resilience goals must acknowledge needs that are both regional in scope and change over time. Flooding does not adhere to political boundaries or agency jurisdictions. Similarly, housing shortages and increasing costs reflect regional housing conditions rather than local jurisdictional boundaries.
Climate adaptation involves anticipating and preparing for future environmental changes. Proactive climate adaptation projects are among the most expensive efforts we will need to pursue in the coming generation. However, we primarily currently fund them by depending on federal resources allocated after natural disasters cause damage. This reactive approach is already unsustainable and needs to be replaced with initiatives that reduce risk before a disaster occurs.
Efforts to tackle housing scarcity and affordability are equally lacking. New housing options arising from zoning changes and land use reforms will take years to develop, as they depend on real estate development cycles that typically span a decade or more. However, the housing assessments intended to guide land use reform — if they are conducted at all — mainly concentrate on current and past conditions. By failing to consider future circumstances, such as shifts in population, household size, deteriorating housing, and flood losses, many of these assessments rely on outdated benchmarks, underestimating the goals they seek to achieve.
Climate-related factors must be integrated into proactive regional housing assessments and paired with supportive land use planning and policies to cultivate more environmentally sustainable, economically vibrant, and affordable communities. Efforts to close the gap between zoned capacity and overall housing needs should consider localized and regional flood risk conditions, along with elements that encourage compact, walkable, and transit-oriented neighborhoods.
Appendix: Soft Site & Buildout Methodology
-
The notes below describe the methodology for the buildout assessment of the project study areas in Nassau, Suffolk, and Westchester counties, for which the National Zoning Atlas (NZA) initiative provided zoning information.
The zoning built-out analysis uses a combination of property data from Corelogic (retrieved via Urban Footprint) and zoning district information from the National Zoning Atlas (NZA). The starting dataset of potential soft sites was based on non-residential and residential lots. Non-residential potential soft sites included the following: vacant, parking, retail 1-story, and low-intensity manufacturing. Residential lots included those underbuilt based on allowable building treatments.
RPA conducted a spatial join with select information from zoning districts governing land use on such parcels. This included populating building treatments allowed by right from corresponding zoning districts as attribute information. RPA also populated the main bulk control measures as parcel attribute data: (i) minimum lot size required, (ii) maximum allowed FAR, and (iii) maximum number of dwelling units per acre.
After this spatial join, we identified residential parcels that are potentially underbuilt by comparing the number of existing units against the allowed building treatments by zoning (ADUs, 1F, 2F, 3F, 4F). If the zoning treatment exceeded the existing units, we considered the residential lot a potential soft site. The result is a spatial dataset of potential soft sites with parcel attributes and high-level zoning district information for approximately 470,000 tax lots, 75,000 non-residential, and 394,000 residential.
-
Using the resulting dataset, RPA conducted a series of tests to remove parcels from the initial soft site selection. With this, we identified potential buildable lots and the corresponding building types allowed (i.e., single-family, two-family, three-family, and four-family or more units).
Flood Risk
RPA excluded parcels affected by existing and future sea-level rise and by permanent and chronic flooding (using NPCC 75% sea-level rise projections for the year 2070).Minimum Lot Size
We further excluded parcels smaller than the applicable minimum lot size required by zoning. To account for potential assemblages (lot mergers), we also measured the percentage of the lot perimeter shared between soft sites (adjacency ratio based on property lines). For the parcels that failed to meet the lot requirement by a small margin, we considered the adjacency ratio to override this step and reflect the possibility of a lot merger.Land Use and Building Treatments Allowed by Zoning
For parcels zoned for 1-, 2-, and 3-family use, we further excluded sites classified for low-intensity retail and industrial use. Locations with these uses were only tested when zoned as 4+ family districts.Built and Allowed FAR
For parcels zoned for 4+ family buildings, we compared an estimated built FAR against the maximum FAR allowed by zoning. If the built FAR of the existing building exceeded a third of the maximum allowed by zoning, such a parcel was removed from the analysis (a site redeveloped to its maximum allowed FAR would need to be at three times the existing built FAR).
To estimate built FAR, RPA used the recorded gross floor area and lot size for every parcel. Information on the maximum allowed FAR was derived from National Zoning Atlas (NZA) data and the spatial join process described above. However, some zoning districts (4+ family buildings) did not include maximum allowable FAR data. To fill this gap, we used the maximum number of units per acre and converted it to a FAR equivalent based on the average floor area of apartment units sold and listed under Zillow. C If units per acre were unavailable, we populated the missing allowable FAR with the weighted average from multifamily districts in the same county and building treatment.
Starting with an initial 75,600 lots, after the fourth screening step, the number is reduced to approximately 12,600. The Minimum lot size test removed almost 35,000 parcels, the most out of any single step in the process.
The residential parcel screening uses a methodology similar to the one described above, with some variations. We first identified residential parcels that are potentially underbuilt by comparing the number of existing units against the allowed building treatments by zoning (ADUs, 1F, 2F, 3F, 4F). If the zoning treatment exceeded the existing units, we considered the lot a potential soft site. We then subjected underbuilt lots zoned for treatments 1F and above (but not ADUs) to a screening process that considered flood risk and minimum lot size, and compared built and allowed density (FAR or DUs/Acre).
For ADUs, we first identified residential lots where zoning allows them by right (regardless of occupancy or other restrictions). From that subset, we retained 7% of the lots for the build-out calculation and randomly selected them across jurisdictions in the study area. The 7% threshold uses ADU construction trends in the Bay Area as a benchmark, where this type of building represented 13% of the total number of units of residential permits issued between 2018 and 2021, a period following California reforms that enabled and incentivized ADUs throughout the state.
Starting with an initial 470,000 lots, the number is reduced to approximately 49,000 parcels after the screening process, or 11% of the total examined.
-
To calculate the build-out capacity on multifamily districts (4+ family buildings), we used lot size information, maximum allowed DUs per Acre, and Floor Area Ratio. For these parcels, the estimated number of units was produced by multiplying the primary bulk control (i.e., DUs per acre) by the lot’s surface area measured in acres. For instances where the primary bulk control was not given in DUs per acre, we relied on the allowed FAR to estimate the total floor area and unit size average from Zillow listings to calculate the maximum number of units.
-
To supplement the buildout estimates on 4+ family sites, we conducted a series of building envelope studies based on the bulk control regulations applicable to higher-density multifamily districts. Wherever necessary, we adjusted the primary bulk control to reflect instances where the maximum DUs per Acre were reduced or capped by secondary dimensional criteria, most frequently by lot coverage, FAR, and on-site parking requirements.
RPA created parametric modeling scripts in Grasshopper, a visual programming language and environment that runs as a plug-in within the Rhinoceros 3D computer-aided design application. Using sample parcel geometries (corresponding to specific districts and bulk requirements as inputs), the scripts produced building envelopes and calculations on the maximum achievable floor area. The script results also determined the number of units a given set of floor plates could accommodate.
The envelope studies indicated the extent to which the primary bulk control (DUs/acre) was capped by other dimensional criteria (i.e., lot cover and parking requirements), meaning that the effective buildable density is less than what the maximum number of dwelling units per acre would suggest. We compared the maximum achievable floor area from the Grasshopper script with the DUs/acre specified by zoning and calculated the difference as a percentage. We found that higher-density districts on Long Island (41+ DUs per acre) allow, on average, 25% to 28% less density than the zoning DU/Acre allowance indicates. In such cases, the primary bulk control was either lot coverage, FAR, or parking requirements. RPA used the percent difference to adjust the DUs/acre for all 4+ family zoning districts in a given county.
-
For the parcels that remained after the screening process, we calculated the maximum number of dwelling units (DUs) allowed on an as-of-right basis, as determined by the corresponding building treatments. For multifamily districts (allowing four or more units), we used lot size information and allowed DUs per Acre to estimate the maximum number of units allowed per site. For multifamily districts where maximum DUs per Acre were unavailable, we used FAR and Zillow listings on sold apartments to estimate an equivalent. The estimated number of units was calculated by multiplying the maximum DUs per acre (either specified by zoning or derived by calculation) by the lot’s surface area, measured in acres.
-
Unit sizes based on Zillow Listings
RPA used Zillow listings to perform several calculations: inform the final step of the soft site screening process (calculating FAR equivalent for density test), determine the number of units from the floor plates produced by envelope studies, and calculate the number of allowed units for instances where the primary bulk control was given in terms of FAR.
The average unit sizes were found by searching and filtering Zillow’s “sold” results for each county boundary. We filtered the “sold” results by Home Type corresponding to the treatment type. Zillow produced a specific quantity of search results. The average unit size was recorded at the median point of the filtered results. Median apartment sizes by county:
Nassau: 1,125 (sqft.)
Suffolk: 1,250 (sqft.)
Westchester: 1,000 (sqft)
